The island’s story

Milandhoo
through time

19472028

379moments 50places 2still to come
Scroll through the years
  1. 1947
  2. 1997
  3. 8 August 1997

    House building begins on Milandhoo

    Atolls Minister Abdulla Hameed inaugurated house building on Milandhoo, then an uninhabited island farmed by people of the atoll. Maakandoodhoo's soil was muddy, its well water had turned foul, its harbour currents capsized boats and its population was growing; Milandhoo was the favourite of three islands its leaders looked at.

    Island history seedsasia.org
  4. 2000
  5. 2000

    First families move

    Families began moving in 2000, in phases as houses were finished: 30 households first, then a second phase of 100 houses. During the move the two islands were run as one, sharing schools and health posts.

    The song of the move to Milandhoo
    Island history atolltimes.mv
  6. 2002
  7. 2003
  8. 2003

    Some families choose Funadhoo

    Not everyone went to Milandhoo: of 23 Maakandoodhoo households that asked to move to Funadhoo, all but four took houses there. By then 116 households had moved to Milandhoo and 152 were still to come.

    Island history seedsasia.org
  9. 2004
  10. 26 December 2004

    Tsunami speeds up the move

    The Boxing Day tsunami hit Maakandoodhoo and sped up the move to Milandhoo.

    Island history en.wikipedia.org
  11. 2005
  12. 20 March 2005

    Declared an inhabited island

    The government officially recognised Milandhoo as an inhabited island.

    Island history en.wikipedia.org
  13. 2006
  14. 2006

    Last families leave Maakandoodhoo

    The last islanders left Maakandoodhoo and the national flag at its island office was taken down for the last time. A song about the move, sung by Rafiyath Rameeza with lyrics by Adam Abdul Rahman, is still widely remembered. Maakandoodhoo has stood empty since.

    Island history atolltimes.mv
  15. 2009
  16. 9 May 2009

    Ali Riza elected MP

    In the first election with single-member seats, Ali Riza won the new Milandhoo constituency with 604 votes (33.5%), ahead of six other candidates. Abdul Rahman Ali came second with 296. The term ran five years.

    Island history stat.elections.gov.mv

  17. 26 October 2009

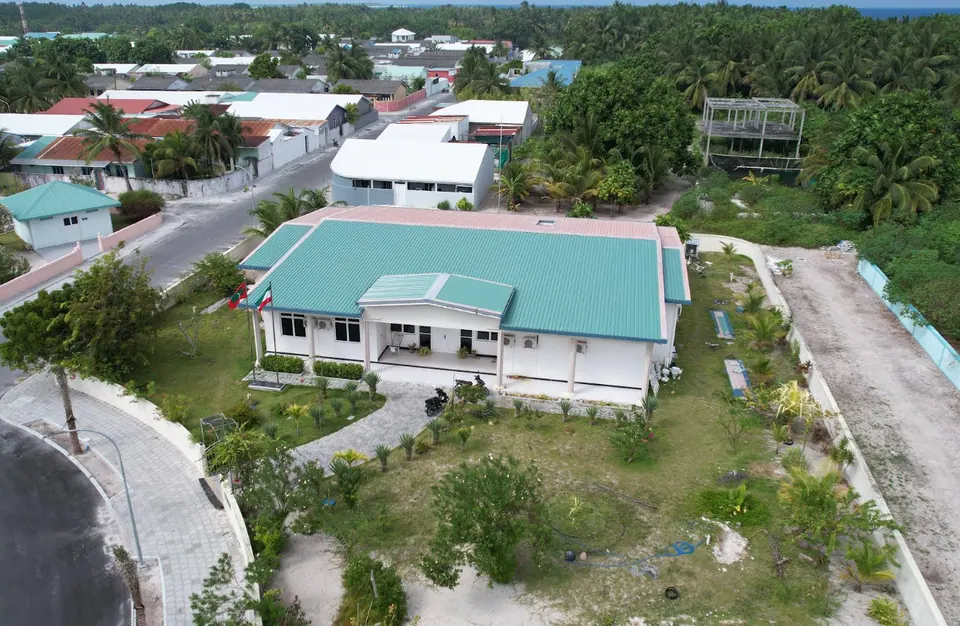

    Atoll capital moved to Milandhoo

    The government moved the Shaviyani Atoll capital and atoll office from Funadhoo to Milandhoo.

    Island history en.wikipedia.org
  18. 2010
  19. 2 March 2010

    President Nasheed visits

    President Nasheed spoke to residents about education and health, and said the atoll transport network would start soon.

    Island history presidency.gov.mv
  20. June 2010

    Majlis votes to restore Funadhoo as capital

    The People's Majlis voted 41–31 to reverse the 2009 move of the atoll capital. President Nasheed sent the bill back, and Milandhoo kept the atoll office for the time being.

    Island history minivannewsarchive.com
  21. 11 October 2010

    Votes for administrative consolidation

    Milandhoo was one of the few islands to vote in favour of the proposal to consolidate small islands' administration.

    Island history minivannewsarchive.com
  22. 2011
  23. 5 February 2011

    First island council elected

    In the Maldives' first local council elections, Milandhoo elected its first five-member island council; the MDP won all five seats.

    Island history minivannewsarchive.com
  24. March 2011

    Atoll office dispute reaches the Supreme Court

    The new atoll council moved its office from Milandhoo to Funadhoo. The two islands' magistrate courts issued conflicting orders, and the Supreme Court ruled the Milandhoo order invalid.

    Island history minivannewsarchive.com
  25. 14 March 2011

    Atoll council budget frozen

    The Shaviyani Atoll Council's budget was halted until a court ruled on the dispute over moving its office from Milandhoo to Funadhoo.

    Island history minivannewsarchive.com
  26. 31 March 2011

    President Nasheed meets the council

    President Nasheed met the island council about developing the harbour, extending the school hall and the planned council building.

    Island history presidency.gov.mv
  27. 6 April 2011

    Capital returns to Funadhoo

    The People's Majlis passed the capital-islands bill a second time with 39 votes, overriding President Nasheed's veto and making Funadhoo the Shaviyani capital again.

    Island history minivannewsarchive.com

  28. 25 December 2011

    President Nasheed opens the harbour

    President Nasheed opened the harbour and launched the sewerage project on a visit to the island.

    Island history presidency.gov.mv
  29. 2012
  30. 12 March 2012

    President Waheed's tour skips Milandhoo

    President Waheed's tour of the atoll left out Milandhoo. MP Ali Riza criticised this, and the President's Office said he would visit soon.

    Island history minivannewsarchive.com
  31. 2014
  32. 18 January 2014

    Second island council elected

    Abdulla Faiz Hasan led the island council elected in 2014, according to the Local Government Authority's list.

    Island history web.archive.org
  33. 22 March 2014

    Hassan Mufeed Abdul Gadir elected MP

    Hassan Mufeed Abdul Gadir (Jumhooree Party) won the Milandhoo constituency, which covers Milandhoo, Feevah and Narudhoo, with 1,096 votes (48.07%). The sitting MP, Ali Riza (MDP), got 1,007, and Abdul Rahman Ali (independent) 177. Turnout was 91.23%.

    Island history stat.elections.gov.mv
  34. 8 September 2014

    Health centre repairs (2014)

    Sh. Atoll Hospital first advertised repair works at the health centre on 7 July 2014. The quotes were too high, so it cancelled that notice and re-advertised on 8 September 2014, then cancelled again for the same reason and re-advertised on 10 November 2014.

  35. 8 September 2014

    Pre-school repairs and furniture (2014)

    The council invited bids on 8 September 2014 for repairs and other works to develop the Milandhoo pre-school, and for electronic equipment and furniture such as chairs and tables, with the contractor supplying materials. The same notice was published again on 11 September 2014.

  36. 2015
  37. 26 February 2015

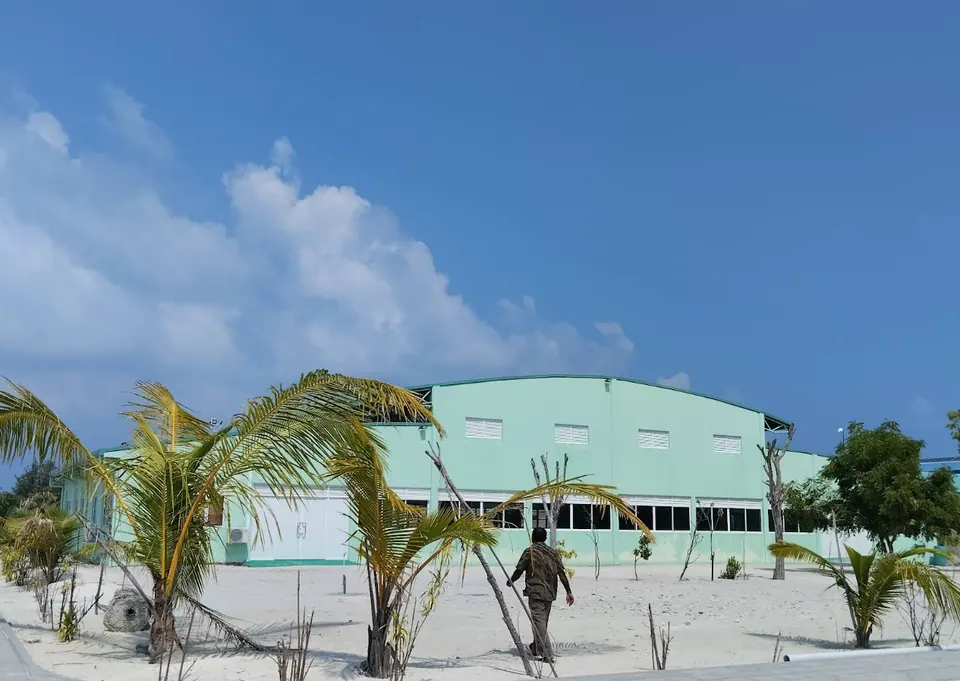

    Four-storey school building

    The Finance Ministry tendered the design and construction of a four-storey building at Milandhoo School for the Ministry of Education on 26 February 2015 (TES/2015/W-07), and republished the notice on 2 March. The bids were higher than reasonable, so it rejected them and re-tendered the work on 9 April 2015.

  38. 17 June 2015

    Finishing the futsal pitch (2015)

    Under the project to build a futsal pitch, the council asked on 17 June 2015 for proposals to finish the unfinished work on the futsal pitch at the Milandhoo Sports Arena, with the contractor supplying the materials. Proposals were due on 24 June 2015.

  39. 29 June 2015

    Electrical wiring for the waste centre

    The Environment Ministry tendered electrical wiring for the waste management centre on 29 June 2015 and re-tendered it on 23 July because too few parties showed interest. The council then tendered the work on 17 August 2015; the prices bid were too high, so it re-tendered on 17 September 2015. The council advertised it again on 28 March 2016 and, cancelling that notice, once more on 11 April 2016.

  40. 3 August 2015

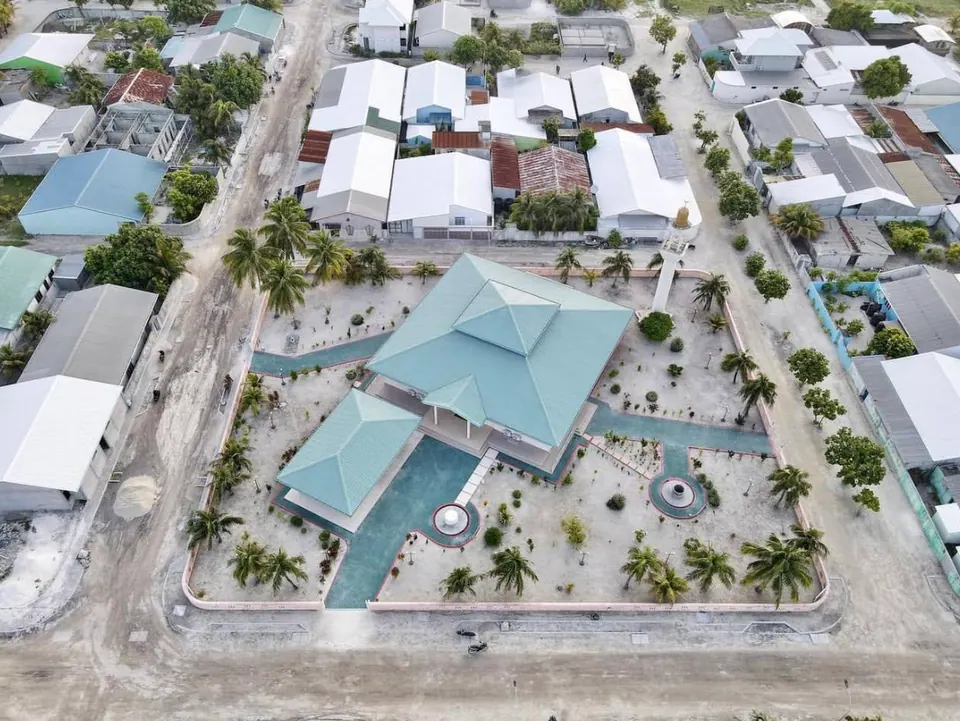

    Repairs to the three mosques (2015)

    The council tendered a list of repairs to Masjid al-Ikraam, Masjid al-Eemaan and Masjid al-Safa on 3 August 2015, including floor paint, roof sheets, lights, speaker wiring and painting. It advertised the work again on 13 August and 27 August 2015, and once more with a revised list on 31 August 2015.

  41. 3 August 2015

    Repairs to the three mosques (2015)

    The council tendered a list of repairs to Masjid al-Ikraam, Masjid al-Eemaan and Masjid al-Safa on 3 August 2015, including floor paint, roof sheets, lights, speaker wiring and painting. It advertised the work again on 13 August and 27 August 2015, and once more with a revised list on 31 August 2015.

  42. 3 August 2015

    Repairs to the three mosques (2015)

    The council tendered a list of repairs to Masjid al-Ikraam, Masjid al-Eemaan and Masjid al-Safa on 3 August 2015, including floor paint, roof sheets, lights, speaker wiring and painting. It advertised the work again on 13 August and 27 August 2015, and once more with a revised list on 31 August 2015.

  43. 2016
  44. 2 May 2016

    Composting equipment and dustbins

    Under the Zone 1 regional waste management project, the Environment Ministry tendered composting equipment and dustbins for the waste centres of nine islands, including Milandhoo, on 2 May 2016, and advertised again on 16 May. On 13 June 2016 it tendered the same items for five Shaviyani islands, then re-tendered on 5 July and 2 August 2016 because too few parties showed interest.

  45. 16 June 2016

    Waste management equipment (OFID, 2016)

    The Finance Ministry tendered waste management equipment for six islands, including Milandhoo, under the OFID phase 2 water, sanitation and waste project (one amendment issued). It was re-tendered for Milandhoo and Komandoo only on 16 June 2016, and the Finance Ministry's site lists the 20 August 2016 notice for the two islands as the third re-tender.

  46. 11 August 2016

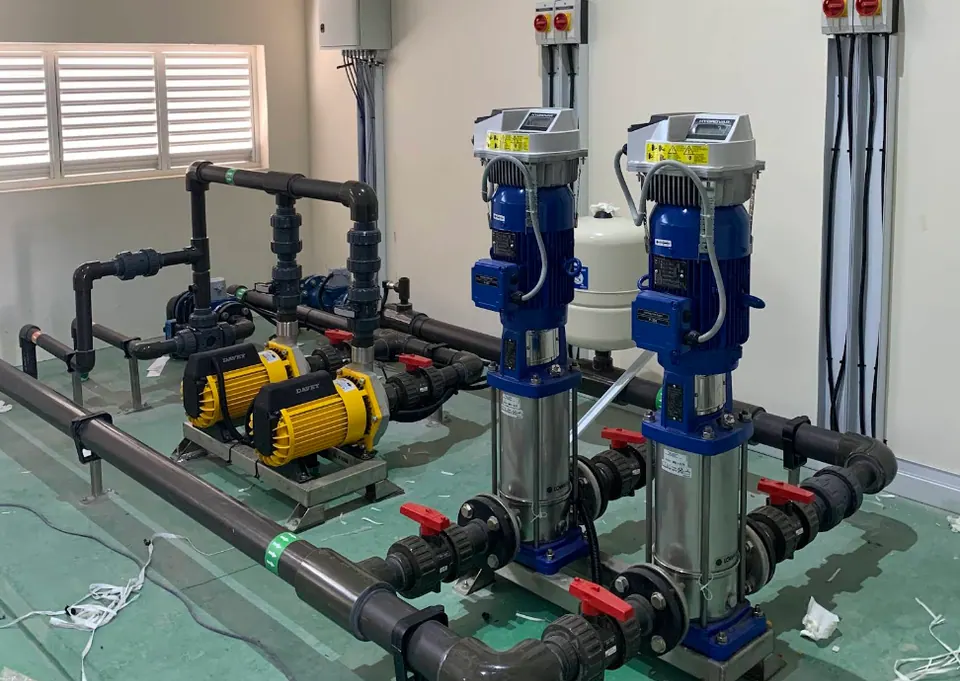

    Water supply system

    The Finance Ministry tendered, for the Environment Ministry, water supply facilities in R. Ungoofaaru and Sh. Milandhoo on 11 August 2016, funded by an OFID loan (W111). Two amendments were issued. Avas reported the contract for both islands, with MWSC, at MVR 87.9 million.

  47. 29 August 2016

    Door repairs and painting (new office)

    As part of its office building project, the council tendered repairs to the doors and door panels, and painting and varnishing, on 29 August 2016, with the contractor supplying the materials. Bids were to be opened on 8 September 2016.

  48. 29 August 2016

    Renovation of the mosques (2016)

    The council tendered repairs to renovate the island's mosques on 29 August 2016, with bids opening on 7 September. It advertised the same work again on 19 September 2016 under the same reference, without giving a reason.

  49. 29 August 2016

    Renovation of the mosques (2016)

    The council tendered repairs to renovate the island's mosques on 29 August 2016, with bids opening on 7 September. It advertised the same work again on 19 September 2016 under the same reference, without giving a reason.

  50. 29 August 2016

    Renovation of the mosques (2016)

    The council tendered repairs to renovate the island's mosques on 29 August 2016, with bids opening on 7 September. It advertised the same work again on 19 September 2016 under the same reference, without giving a reason.

  51. 29 October 2016

    Wall and toilet repairs (new office)

    As part of its office building project, the council tendered repairs to the inside and outside walls and to the toilets of the building on 29 October 2016, with the contractor supplying the materials. Bids were due and opened on 8 November 2016.

  52. 2017
  53. 6 February 2017

    Waste management equipment (five islands, 2017)

    The Finance Ministry tendered, for the Environment Ministry, waste management equipment for five Zone 1 islands (Sh. Goidhoo, Sh. Maaungoodhoo, Sh. Milandhoo, Sh. Komandoo and Hdh. Nolhivaramfaru) on 6 February 2017, and re-tendered it on 14 March 2017 because the first call drew too little response.

  54. 6 May 2017

    Third island council elected

    Abdulla Faiz led the island council again, with Ahmed Shiyam as vice president.

    Island history web.archive.org
  55. 18 August 2017

    Heavy rain floods homes

    Heavy rain flooded homes on the island.

    Island history avas.mv
  56. 10 December 2017

    Waterspout damages houses

    A waterspout hit the island and damaged houses, three of them badly.

    Island history avas.mv
  57. 2018
  58. 13 January 2018

    Ceiling falls in the new building

    Days after the new four-storey building was handed over, part of a classroom ceiling fell. The council raised concerns about the build quality; the contractor, SJ Construction, rejected those claims but said repairs had begun.

  59. 8 February 2018

    Two-tonne pickup for waste (2018)

    The council sought quotes for a two-tonne pickup for waste management on 8 February 2018. No one bid, so it cancelled that notice and advertised again on 22 February 2018; after no one bid on that notice either, it advertised again on 11 March 2018. The prices bid then were too high, and it advertised once more on 25 November 2018.

  60. 12 February 2018

    Repairs to the island's mosques (2018)

    The council tendered the renovation of the island's mosques and the places in its care on 12 February 2018. No bids came in, so it cancelled that notice and re-tendered some repair works at the mosques on 6 March 2018.

  61. 12 February 2018

    Repairs to the island's mosques (2018)

    The council tendered the renovation of the island's mosques and the places in its care on 12 February 2018. No bids came in, so it cancelled that notice and re-tendered some repair works at the mosques on 6 March 2018.

  62. 12 February 2018

    Repairs to the island's mosques (2018)

    The council tendered the renovation of the island's mosques and the places in its care on 12 February 2018. No bids came in, so it cancelled that notice and re-tendered some repair works at the mosques on 6 March 2018.

  63. 3 July 2018

    President Yameen visits

    President Yameen visited the island and opened the sewerage system.

    Island history presidency.gov.mv
  64. 13 December 2018

    Laboratory desks and chairs

    Milandhoo School tendered the supply of desks and chairs for its laboratory on 13 December 2018. No one bid, so it was cancelled and advertised again on 24 December 2018, and again on 27 February 2019 after the second round also drew no bids.

  65. 2019
  66. 13 January 2019

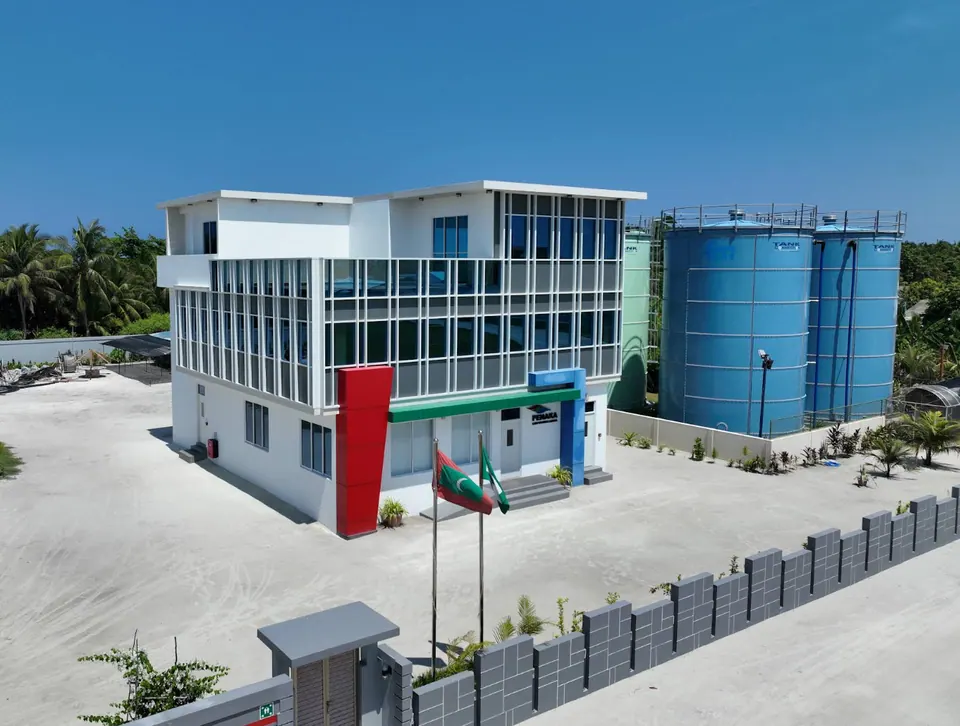

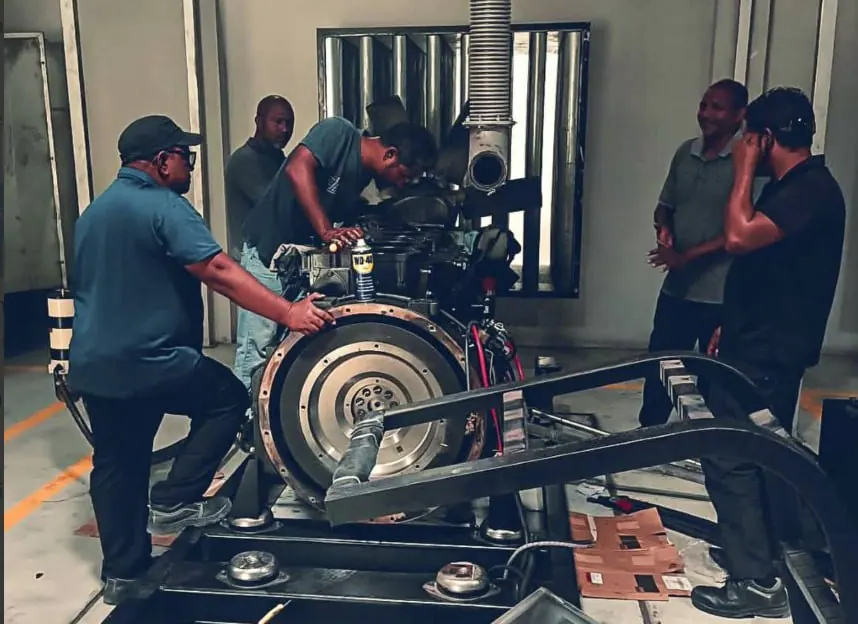

    Oil room, engine bed and cable trench

    Fenaka tendered building an oil room, an engine bed and a cable trench at the Milandhoo powerhouse on 13 January 2019. The bids were found too expensive, so it cancelled and re-tendered the work on 30 January 2019, and for the same reason again on 19 February 2019.

  67. 6 April 2019

    Ali Riza elected MP again

    Ali Riza "Ayya" (MDP) won back the Milandhoo constituency with 1,069 of 2,552 valid votes. Ali Rasheed Hassan (independent) got 724, the sitting MP Hassan Mufeed Abdul Gadir, now with the PPM, 554, and Ibrahim Mansoor (JP) 205.

    Island history stat.elections.gov.mv
  68. 15 April 2019

    Fitting doors at the school (2019)

    Milandhoo School had tendered fitting doors, with the contractor supplying the materials, under notice GS69/BUDGET/2019/001. Only one party applied, so on 15 April 2019 the school cancelled that notice and tendered the work again, with bids opening on 25 April 2019.

  69. 17 June 2019

    Pickup for waste collection (2019)

    The council sought quotes for a pickup for waste management on 17 June 2019 and re-advertised on 3 July, 14 July and 31 July 2019 because no one bid or attended. The party chosen under the 31 July notice then said it could not supply the pickup as specified, so the council re-advertised on 24 October 2019, and again on 14 November 2019 because the prices were too high.

  70. 6 October 2019

    Repairs to the waste management centre (2019)

    The council first advertised repairs to the waste management centre, with the contractor supplying the materials, on 22 September 2019. Nobody submitted a quote, so it cancelled that notice and advertised the work again on 6 October 2019, with quotes due on 16 October 2019.

  71. 24 October 2019

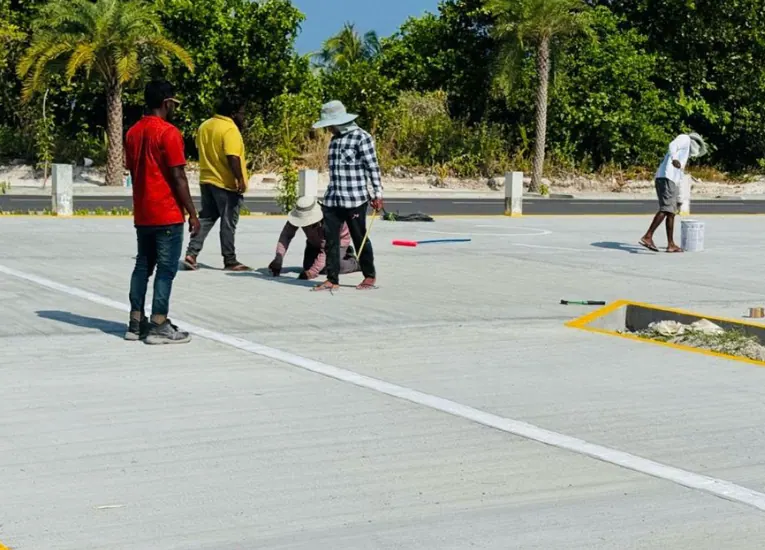

    Sub-base for the football ground

    The youth ministry invited quotes to prepare the sub-base of the football ground on 24 October 2019. It cancelled that notice because it did not get three valid bids and the details had changed, and re-tendered on 4 December 2019.

  72. 12 November 2019

    Third-floor ceiling repairs at the school

    Milandhoo School tendered repairs to the ceiling of its third floor on 12 November 2019. Only one party applied, so it tendered the work again on 28 November 2019, with the contractor supplying the materials. The bidders in that round were disqualified, so it tendered a third time on 19 December 2019, with bids opening on 29 December 2019.

  73. 27 November 2019

    New door locks and magnets at the school

    Milandhoo School tendered replacing the door locks and fitting door magnets in its building on 27 November 2019. That notice had the wrong dates, so the school cancelled it and advertised again on 1 December 2019, with bids opening on 12 December 2019.

  74. 27 November 2019

    Repairs to the students' toilets

    Milandhoo School tendered repairs to the students' toilet sets on 27 November 2019. That notice had the wrong dates, so the school cancelled it and advertised again on 1 December 2019, with bids opening on 12 December 2019.

  75. 22 December 2019

    Powerhouse wall, panel room and chimney

    Fenaka tendered building a boundary wall for the powerhouse, a high-voltage panel room, a chimney and workshop works on 22 December 2019, and re-tendered them on 7 January 2020 because the first notice drew too little response.

  76. 2020
  77. 13 January 2020

    Fitting doors at the school (2020)

    Milandhoo School tendered fitting doors, with the contractor supplying the materials, on 13 January 2020. Nobody applied, so it tendered the work again on 30 January 2020, and once more on 10 February 2020 when the second round also drew no bidders; bids were to open on 27 February 2020.

  78. 17 August 2020

    Artificial turf contract awarded

    One contract covered new turf for the football grounds of Funadhoo, Fokaidhoo and Milandhoo. The Finance Ministry's awarded-projects list shows it awarded to V.A.M & Company Pvt Ltd for MVR 9,969,706.80 over 120 days, for all three grounds.

  79. 11 September 2020

    New building under contractor finance

    On 11 September 2020 the Finance Ministry tendered, for the Ministry of Health, a new health centre building for Milandhoo to be built under contractor finance, in the same notice as Hinnavaru and Vilufushi (TES/2020/W-062). The invitation was amended on 26 October 2020, with bids due on 25 November 2020. The tender page carries a cancellation notice for the invitation.

  80. 2021
  81. 3 February 2021

    Government to take the island back

    The Fisheries Ministry, which had leased Nalandhoo long-term, said the government would take it back for state use, together with Hd. Hondaidhoo and N. Minaavaru, and sought a valuation audit of the investments made on the islands. It re-advertised the audit in March 2021, giving priority to bidders from the region.

  82. 10 April 2021

    Abdulla Athif elected council president

    In the first election where island council presidents were chosen directly, Abdulla Athif ("Athif Bodey") became president. The members were Saifulla Usman (vice president), Ahmed Shiyam, and Fathimath Sarumeela and Fathimath Zahiyya in the two seats for women. Mohamed Shiyam of Milandhoo became president of the Shaviyani Atoll Council.

  83. 10 April 2021

    Abdulla Athif elected council president

    Voters chose the island council president directly for the first time and elected Abdulla Athif. Mohamed Shiyam of Milandhoo became president of the Shaviyani Atoll Council.

    Island history web.archive.org
  84. 29 November 2021

    Boundary wall and fence for the ground

    The council tendered building a boundary wall and fence around the football ground on 29 November 2021, with the council supplying materials, and published an English version on 30 November. The gazette marks the Dhivehi notice as cancelled.

  85. 2022
  86. 13 June 2022

    Walkway at the school

    Milandhoo School tendered a walkway on 13 June 2022 (GS69/BUDGET/2022/005), and bids were opened on 21 June 2022. Six parties registered and two submitted bids. On 28 June 2022 the school published the award to Anara Maldives Private Limited for MVR 285,000 over 18 days.

  87. 2022

    Solar-diesel hybrid system

    By July 2022 Milandhoo had a solar-diesel hybrid power system built under the ADB-funded POISED project (Preparing Outer Islands for Sustainable Energy Development): 247 kWp of solar panels, a 280 kWh battery and a 400 kW diesel generator.

  88. 2023
  89. 12 February 2023

    Repairs to the three mosques (2023)

    The council tendered repairs to Masjid al-Eemaan, Masjid al-Ikraam and Masjid al-Safa on 12 February 2023. One bid was evaluated, and the work was awarded on 26 February 2023 to Salaam Investment for MVR 99,000 over 20 days. The award was published on 30 March 2023.

  90. 12 February 2023

    Repairs to the three mosques (2023)

    The council tendered repairs to Masjid al-Eemaan, Masjid al-Ikraam and Masjid al-Safa on 12 February 2023. One bid was evaluated, and the work was awarded on 26 February 2023 to Salaam Investment for MVR 99,000 over 20 days. The award was published on 30 March 2023.

  91. 12 February 2023

    Repairs to the three mosques (2023)

    The council tendered repairs to Masjid al-Eemaan, Masjid al-Ikraam and Masjid al-Safa on 12 February 2023. One bid was evaluated, and the work was awarded on 26 February 2023 to Salaam Investment for MVR 99,000 over 20 days. The award was published on 30 March 2023.

  92. 23 February 2023

    Cemetery gate

    The council tendered making and fitting a gate for the cemetery on 23 February 2023 and advertised it again on 9 August 2023. On 30 August 2023 it announced the winner, together with a tender for 80 date palms for the island's roads: Salaam Investment, for MVR 96,500 over 45 days.

  93. 23 February 2023

    Automatic doors for the garage

    The council tendered the supply and installation of an automatic door set for its vehicle garage on 23 February 2023. One bid was evaluated, and the work was awarded on 27 March 2023 to FZ Investment for MVR 130,000 over 120 days. The award was published on 30 March 2023.

  94. 13 March 2023

    Review of the island's land use plan

    The council tendered reviewing the island's land use plan and preparing a new one on 13 March 2023, with an amendment on 19 March. On 27 March 2023 the work was awarded to Terra Plan Pvt Ltd for MVR 119,000 over 40 days.

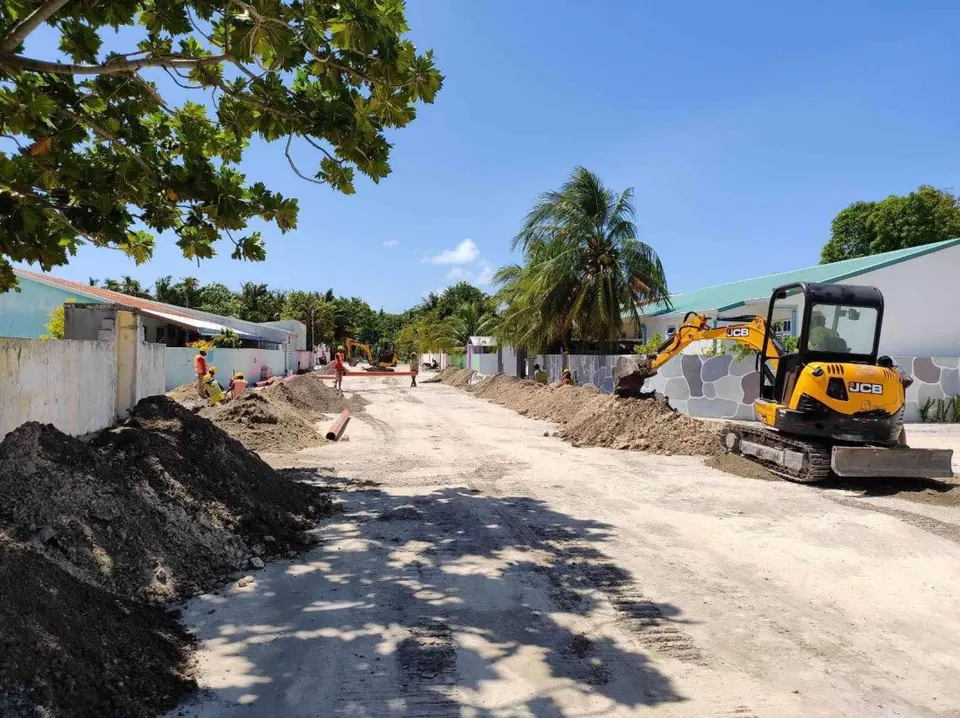

  95. 4 June 2023

    Agreement with India to fund the track

    India and the Maldives exchanged an agreement to develop the Sh. Milandhoo running track, one of 10 signed during Indian Minister of State V Muraleedharan's visit. It comes under India's High Impact Community Development Projects, which fund small community projects on the islands.

  96. 11 June 2023

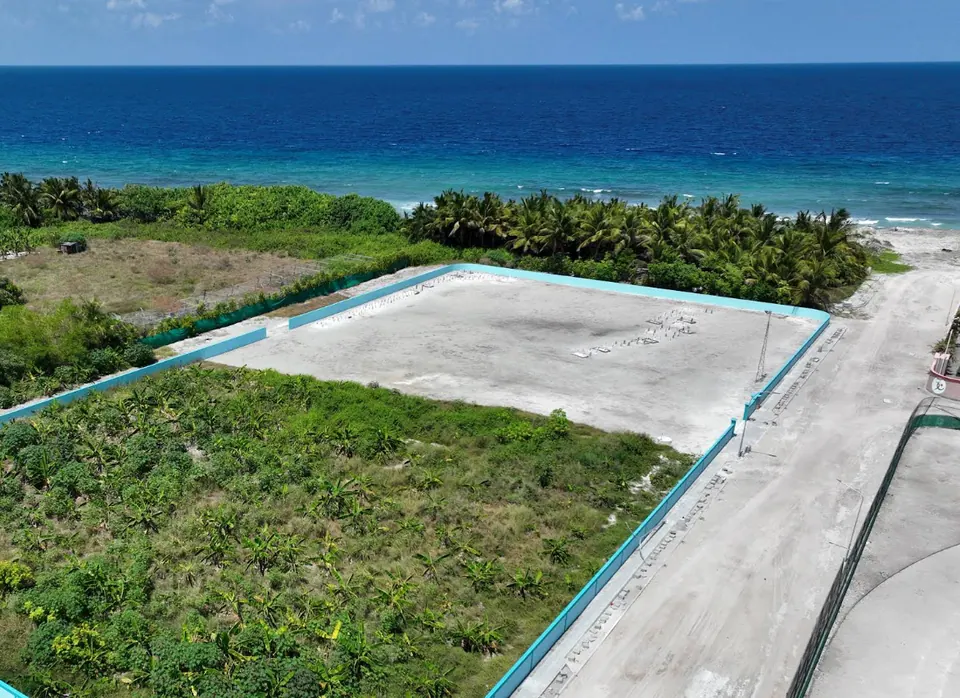

    Turf for the school assembly ground

    Milandhoo School tendered the supply of turf for its assembly ground on 11 June 2023 (GS69/BUDGET/2023/002), and bids were opened on 19 June 2023. Five parties registered and two submitted bids. On 21 June 2023 the school published the award to Best Circle for MVR 349,000 over 10 days.

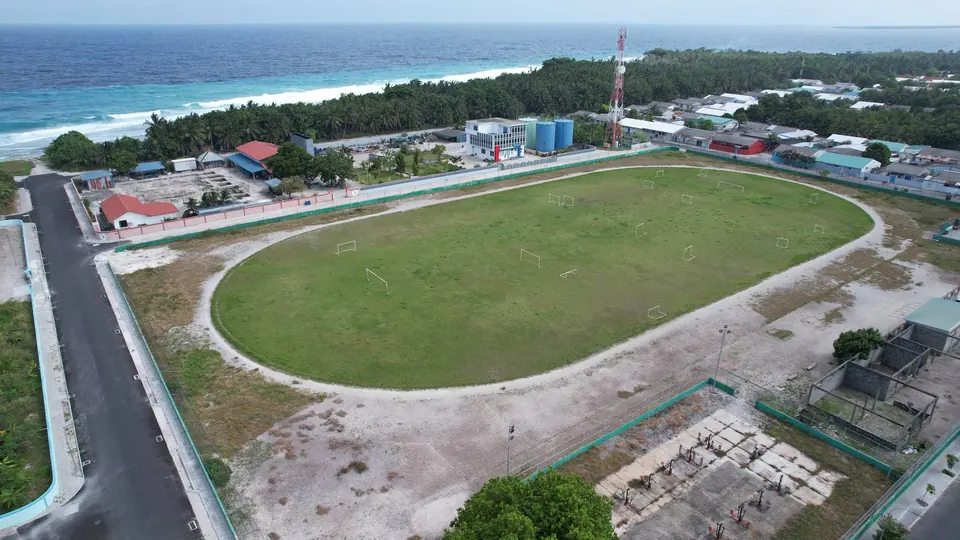

  97. 1 August 2023

    President Solih visits

    President Solih opened the upgraded football ground and the new Fenaka office, and made pledges at a rally that night.

    Island history presidency.gov.mv
  98. 10 August 2023

    Air conditioners for the council

    The council sought nine inverter air conditioners for its own use on 10 August 2023. It corrected the information sheet and advertised again on 22 August 2023: two of 36,000 BTU, three of 24,000 BTU, three of 18,000 BTU and one of 9,000 BTU. The winner was announced on 19 October 2023.

  99. 21 August 2023

    First resort tender

    The Ministry of Tourism invited bids (IFB (IUL)88-PS/88/2023/62) to lease Nalandhoo and Ha. Medhafushi for resorts. Nalandhoo: 63.99 hectares, at least 200 beds, a 50-year lease, at least 36 months to build, a minimum lease cost of USD 1 million due within 60 days of the award, and proof of USD 10 million in funds. A pre-bid meeting was held on 30 August, and bids were due by 10:00 on 21 September 2023.

  100. 2024
  101. 2024

    In the national budget

    The 2024 approved budget lists a boat yard with a slipway in Milandhoo as a new project (P-HBR221-001) under the Ministry of Construction and Infrastructure: MVR 500,000 for 2024, with MVR 2.5 million planned for 2025 and MVR 200,000 for 2026. Source: 2024 Approved Budget Tables, sheet 5.2 "PSIP by island list".

  102. 2024

    In the national budget

    The 2024 approved budget lists a "state-of-the-art TVET institute" in Milandhoo as a new project (P-UNI023-001) under the Ministry of Higher Education: MVR 450,000 for 2024, with MVR 1.35 million planned for 2025 and MVR 1.8 million for 2026. Source: 2024 Approved Budget Tables, sheet 5.2 "PSIP by island list".

  103. 2024

    In the national budget

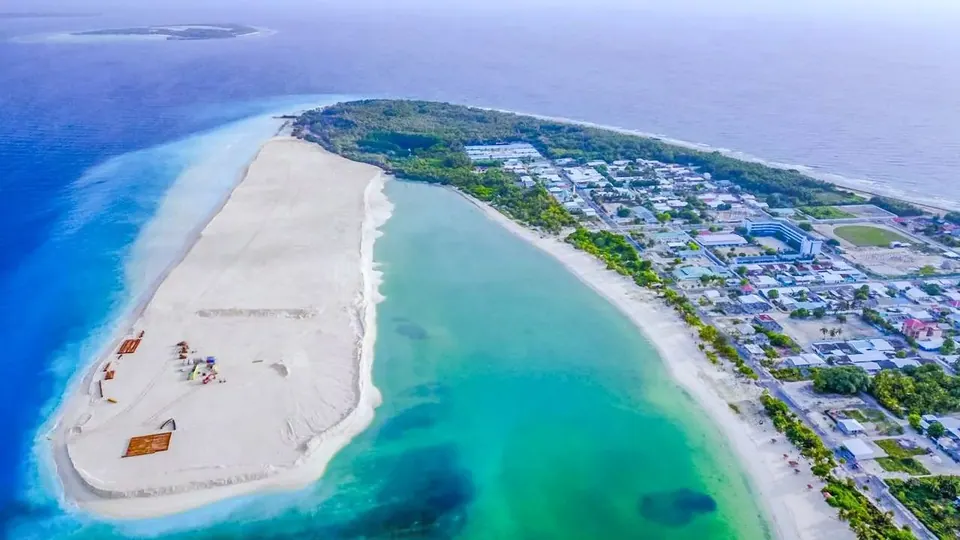

    The 2024 approved budget lists a 14-hectare reclamation of the west lagoon with a revetment as a new project (P-REC066-001) under the Ministry of Construction and Infrastructure: MVR 1.7 million for 2024, with MVR 4 million planned for 2025 and MVR 5 million for 2026. Source: 2024 Approved Budget Tables, sheet 5.2 "PSIP by island list".

  104. 2024

    In the national budget

    The 2024 approved budget lists a synthetic running track for Milandhoo (P-SOC119-001) under the Ministry of Youth and Sports, at the pre-tendering stage: MVR 290,307 for 2024, with MVR 177,000 planned for 2025 and MVR 17,700 for 2026. Source: 2024 Approved Budget Tables, sheet 5.2 "PSIP by island list".

  105. 17 January 2024

    Repairs to the three mosques (2024)

    The council tendered repairs to Masjid al-Eemaan, Masjid al-Ikraam and Masjid al-Safa on 17 January 2024. Three bids came in (MVR 355,725 to 806,263.80), and the work was awarded on 1 February 2024 to Saxu Collection for MVR 355,725 over 45 days. The award was published on 8 February 2024.

  106. 17 January 2024

    Repairs to the three mosques (2024)

    The council tendered repairs to Masjid al-Eemaan, Masjid al-Ikraam and Masjid al-Safa on 17 January 2024. Three bids came in (MVR 355,725 to 806,263.80), and the work was awarded on 1 February 2024 to Saxu Collection for MVR 355,725 over 45 days. The award was published on 8 February 2024.

  107. 17 January 2024

    Repairs to the three mosques (2024)

    The council tendered repairs to Masjid al-Eemaan, Masjid al-Ikraam and Masjid al-Safa on 17 January 2024. Three bids came in (MVR 355,725 to 806,263.80), and the work was awarded on 1 February 2024 to Saxu Collection for MVR 355,725 over 45 days. The award was published on 8 February 2024.

  108. 27 February 2024

    President Muizzu visits

    President Muizzu met the council and the Women's Development Committee and pledged an airport for the island.

    Island history presidency.gov.mv
  109. 3 March 2024

    New waste shed

    The council tendered building a waste shed on 3 March 2024 and opened the bids on 18 March. All the prices bid were above the council's estimate, so it cancelled that tender, revised the specification and drawings, and re-tendered on 20 May 2024, with bids opened on 29 May. No award for the shed has been published in the gazette.

  110. 21 April 2024

    Hassan Mufeed Abdul Gadir elected MP again

    Hassan Mufeed Abdul Gadir "Hasana" (People's National Congress) won the Milandhoo constituency with 1,411 votes (53.61%). The sitting MP, Ali Riza (MDP), got 1,194 (45.36%), and Mohamed Nabeel (independent) 27. Turnout was 87.46%.

  111. 7 August 2024

    Playsets and turf for the park

    The council tendered the supply and installation of playsets for the children's park, and turf for the park's two football pitches, on 7 August 2024. Three bids came in (MVR 450,000 to 987,376.38), and the work was awarded on 25 August 2024 to Khaleel Brothers Private Limited for MVR 450,000 over 135 days. The award was published on 2 September 2024.

  112. October 2024

    Tugboat grounding damages the reef

    The foreign tugboat Shwe Lin Yone ran aground on Milandhoo's reef and destroyed about 477 m² of coral. In November 2025 its owner was fined MVR 12 million.

    Island history atolltimes.mv
  113. 7 November 2024

    Named in STO’s fuel station project

    President Mohamed Muizzu launched STO's project to set up fuel storage in every atoll. Sh. Milandhoo was among the islands where a fuel setup was to be completed by February 2026, to give fishermen and the public fuel at STO rates.

  114. 2025
  115. 22 April 2025

    200 housing units

    The Finance Ministry opened prequalification for the design and building of 200 housing units in Sh. Milandhoo on 22 April 2025 (TES/2025/W-043, international bidding). The deadline was extended four times, with six addenda and two clarifications, and submissions closed on 16 June 2025.

  116. 21 July 2025

    Painting the new building and pre-school rooms

    Milandhoo School invited bids on 21 July 2025 to paint its new building and the pre-school classrooms. Its award sheet, published on 10 August 2025, names Cocc Pvt Ltd at MVR 525,000 over 25 days, but the gazette later marked that notice as cancelled.

  117. 7 August 2025

    Park phase 2

    The council tendered phase 2 of the park development on 7 August 2025. The prices bid were higher than the council's estimate, so it cancelled the notice, revised the specification and drawings, and re-tendered on 28 August 2025, then for the same reason again on 9 September 2025.

  118. 15 October 2025

    President Muizzu visits again

    President Muizzu met the council and launched projects including the airport agreement, the new hospital, road and coastal protection work, and passport services.

    Island history presidency.gov.mv
  119. 20 October 2025

    Reception counter and reception area works

    The health centre invited estimates on 20 October 2025 to enlarge the reception counter area, build a new counter to its design and carry out some repairs in the reception area. That notice was cancelled, and the work was advertised again under the same reference on 30 November 2025.

  120. 15 December 2025

    Turf for the play area

    The council tendered the supply and installation of turf for the Ranvilu Park play area on 15 December 2025. The winning bidder withdrew and the second-ranked price was above the council's estimate, so the council re-tendered on 21 January 2026. It was awarded on 3 February 2026 to His Star Investment for MVR 121,000 over 18 days.

  121. 2026
  122. 21 January 2026

    D-boards for the street lights

    The council tendered materials for fitting D-boards on Milandhoo's street lights on 21 January 2026. It cancelled that notice to change the information sheet and re-tendered on 22 January 2026. The supply was awarded on 3 February 2026 to RDN Investment for MVR 220,000 over 5 days.

  123. 10 February 2026

    MTCC unable to build temporary mosque

    The council said MTCC had confirmed it could not build the temporary mosque the government had promised after the old mosque was demolished, so the council began converting the Quran Centre with its own funds.

  124. 4 April 2026

    Ibrahim Nihaad elected council president

    Ibrahim Nihaad (MDP) won the presidency with 887 votes (53.56%), against the sitting president Abdulla Athif (PNC) with 769. Elected members: Saifulla Usman (PNC, 840) and Ibrahim Alim (MDP, 752), who became vice president; and in the women's seats Fathimath Nasheedha (PNC, 850) and Aishath Haniyya (MDP, 681). Turnout was 90.44%.

  125. 4 April 2026

    Ibrahim Nihaad elected council president

    Ibrahim Nihaad (MDP) beat the sitting council president Abdulla Athif with 887 votes to 769. Turnout was 90.44%.

  126. 1 July 2026

    Repairs to al-Eemaan and al-Safa (July 2026)

    The council tendered repair works at Masjid al-Eemaan and Masjid al-Safa on 1 July 2026. The prices bid were higher than the council's estimate, so it cancelled that notice, changed the works and re-tendered them on 13 July 2026.

  127. 1 July 2026

    Repairs to al-Eemaan and al-Safa (July 2026)

    The council tendered repair works at Masjid al-Eemaan and Masjid al-Safa on 1 July 2026. The prices bid were higher than the council's estimate, so it cancelled that notice, changed the works and re-tendered them on 13 July 2026.

  128. 6 August 2026

    Repairs to the temporary hinavaage

    The council tendered repairs to the island's temporary hinavaage, the house where a person who has died is washed and prepared for burial, on 6 August 2026. On 18 August 2026 the work was awarded to Mubeen Investment for MVR 80,000 over 10 days.

  129. 6 August 2026

    Resort tender reopened

    The Ministry of Tourism and Aviation reopened the tender for a resort of at least 200 beds on Nalandhoo: a 50-year lease, at least 36 months to build, a minimum lease acquisition cost of USD 1 million and proof of USD 10 million in funds. Bids are scored 90% on the price offered and 10% on a contribution to the Tourism Trust Fund's training fund.

  130. 14 October 2026

    Waiting area and counter works at the court

    The Magistrate Court tendered repairs to its waiting area and work to separate the counter from the office section on 14 October 2026, with the contractor supplying the materials. Bidders had to register by 25 October, and bids were to be opened at the court on 28 October 2026.

  131. 20 October 2026

    Work idle at 53%

    MTCC's project tracker lists the harbour upgrade (PRJ-00544) as idle, 53% complete, in its update of 20 October 2026. It was awarded to MTCC on 8 December 2022 with completion planned for 5 January 2025. The work covers 99,238 cbm of dredging, a 316 m quay wall, 701 m of rock shore protection, a 130 m jetty, a 74 m bridge and 3,863 sqm of paving.

  132. Today
  133. 2028
  134. The story keeps going

    See what’s being built right now, or explore the island.
