Milandhoo Airport

Milandhoo Airport

Public project

  1. Planned
  2. Under construction
  3. Open
Started
Agreement 15 Oct 2025
Expected
2028

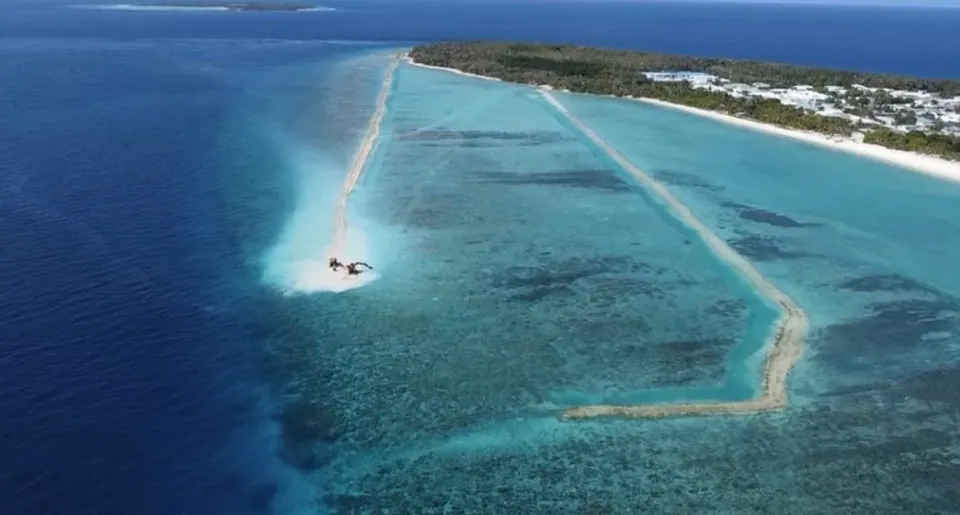

21 hectares reclaimed in April–May 2026. The harbour is being moved to make room.

About

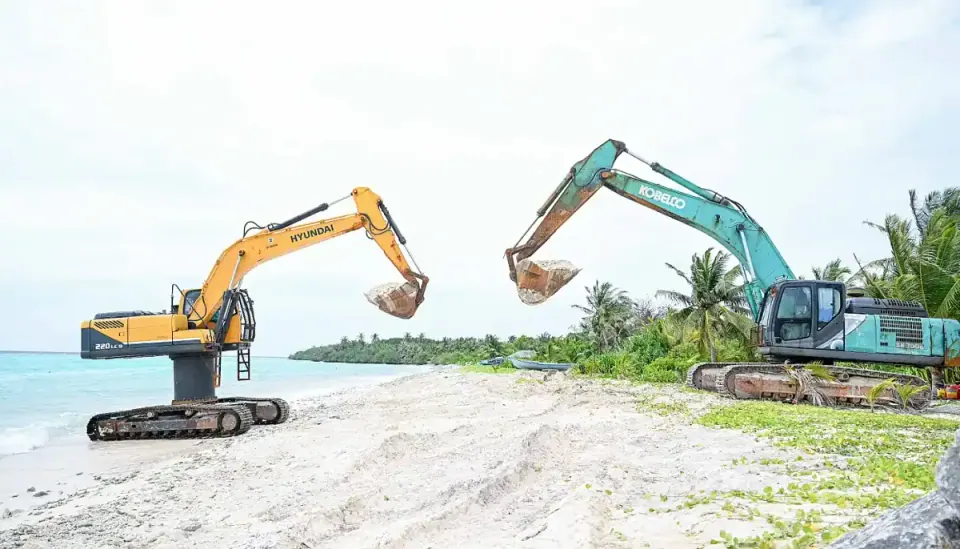

Milandhoo's own airport is being developed by Maldives Airports Company Limited (MACL), which signed the agreement during President Muizzu's visit on 15 October 2025. The agreement covers 40 hectares of land reclamation, the airport itself, and moving the island's harbour to a new, larger one. Reclamation was carried out by Peninsula Infrastructure, an MACL subsidiary, using the dredger Queen of the Netherlands: 21 hectares were reclaimed with about 1.13 million cubic metres of sand between 3 April and 4 May 2026. With a further 4.9 hectares cleared on the existing island, the airport site covers 25.9 hectares. The government says the airport will be finished and in use within 30 months of the agreement, around April 2028.

#airport#project#macl#transport

Key facts

Developer
Maldives Airports Company Limited (MACL)1
Reclamation contractor
Peninsula Infrastructure Pvt Ltd (wholly owned MACL subsidiary, set up 6 Oct 2025)2
Reclamation in agreement
40 ha (within 8 months)1
Land reclaimed
21 ha2
Sand placed
About 1,134,534 m³2
Airport site
25.9 ha (21 ha reclaimed + 4.9 ha cleared on the island)2
Dredger
Queen of the Netherlands (35,000 m³ hopper, Boskalis)3
Reclamation time
31 days4
Includes
Relocation of the existing harbour to a new, larger harbour5
Design
Airstrip laid out to link with planned inner and outer road networks6
Completion target
Within 30 months of 15 Oct 20251
  1. 1presidency.gov.mv
  2. 2mbr.mv
  3. 3psmnews.mv
  4. 4standard.mv
  5. 5en.mmtv.mv
  6. 6en.mmtv.mv
  1. 2028
  2. 2028Planned

    Expected to open

    Due within 30 months of the October 2025 agreement.

    en.mmtv.mv
  3. Now
  4. 2026
  5. 4 May 2026· 6 months ago

    Land reclamation finished

    21 hectares reclaimed in 31 days; the whole site covers about 26 hectares.

    mbr.mv
  6. 26 April 2026

    Dredging 42% complete

    MACL reported 11 hectares reclaimed, 42% of the dredging. The dredger Queen of the Netherlands carries up to 35,000 m³ of sand a load.

    psmnews.mv
  7. 6 April 2026

    Council reports reclamation halted

    The island council said reclamation stopped on 6 April at about 3% complete and linked it to the 4 April election results. Work later resumed and finished on 4 May.

    raajje.mv
  8. 3 April 2026

    Land reclamation begins

    The dredger Queen of the Netherlands starts pumping sand for the airport.

    mbr.mv
  9. 2025
  10. 15 October 2025

    Agreement signed

    The government agreed with Maldives Airports Company (MACL) to build the airport and a new harbour.

    en.mmtv.mv
  11. 15 October 2025

    President sets a 30-month deadline

    During his visit to Milandhoo, President Muizzu said the airport, including the harbour development and relocation, will be finished and in use within 30 months. The 40-hectare land reclamation, contracted the same day, was scheduled to take eight months.

    presidency.gov.mv
  12. 6 October 2025

    MACL sets up Peninsula Infrastructure

    MACL founded the subsidiary Peninsula Infrastructure for large reclamation and dredging work; it later reclaimed the Milandhoo airport land.

    mbr.mv
  13. 6 February 2025

    Named in the Presidential Address

    In his Presidential Address, President Muizzu listed Shaviyani Milandhoo among the islands where new airport developments would begin.

    presidency.gov.mv

Reviews

No reviews yet. Been here? Be the first to share how it was.

Rate Milandhoo Airport

Sign in with Telegram to write a review — it keeps reviews real. One tap, no password.

Been here? Add your photos Help other visitors see what Milandhoo Airport is like.

Photos of Milandhoo Airport

Sign in with Telegram to share photos — one tap, no password. We’ll tell you on Telegram when they’re added.

More ways to get around
